Ch 3 - Project Management

  1. Introduction        (p59)
    1. Def - Project - a series of related tasks directed toward a major output that usually requires a long completion time.
    2. Examples - constructing a building, developing a new product, auditing a company, merging two organizations
  2. Project Scheduling       (p61)
    1. Determining:
      1. Activities - tasks which make up the project
      2. Precedent relationships - activities which must be completed before another activity can start
      3. Activity time - time it takes to perform an activity
  3. Gantt Chart         (p61)
    1. Def - Gantt Chart - a popular tool for scheduling small projects
    2. Example - Servicing a Jet during a Layover - Fig 3.4, p61
  4. Critical Path Method        (p63)
    1. Def - Basic Critical Path Method (CPM) - a method to determine the activities which are critical to completing a project on time.
    2. Example 1 - Milwaukee Paper - p65
            Activity

      Precedent
        Relationship

      Activity
        Time (weeks)

        A – Build internal components
        B – Modify
      roof and floor
        C – Construct collection stack

        D – Pour concrete and install frame
        E –
      Build high-temperature burner
        F
      – Install pollution control system

        G – Install air pollution device
        H –
      Inspect and test



      A

      A, B
      C
      C

      D, E
      F, G

      2
      3
      2

      4
      4
      3

      5
      2

  5. *Basic CPM Procedure
    1. Use Precedent Relationships to draw Network Diagram - see below.
    2. Compute earliest start (ES) time and earliest finish (EF) time for each activity (p69)
      1. ES of activities with no precedent relationships = 0
      2. EF for a given activity = its ES + its activity time
      3. ES for a given activity = largest EF of the immediately preceding activities.
    3. Compute latest start (LS) time and latest finish (LF) time for each activity (p71)
      1. LF of any final activity = the largest EF
      2. LS for a given activity = its LF - its activity time
      3. LF for a given activity = smallest LS of the immediately succeeding activities.
    4. Compute slack time for each activity: Slack = LS – ES
    5. Identify the critical path
      An activity is on the critical path if its slack time = 0.
      Note: If an activity on the critical path takes longer than estimated, then final date will be affected.

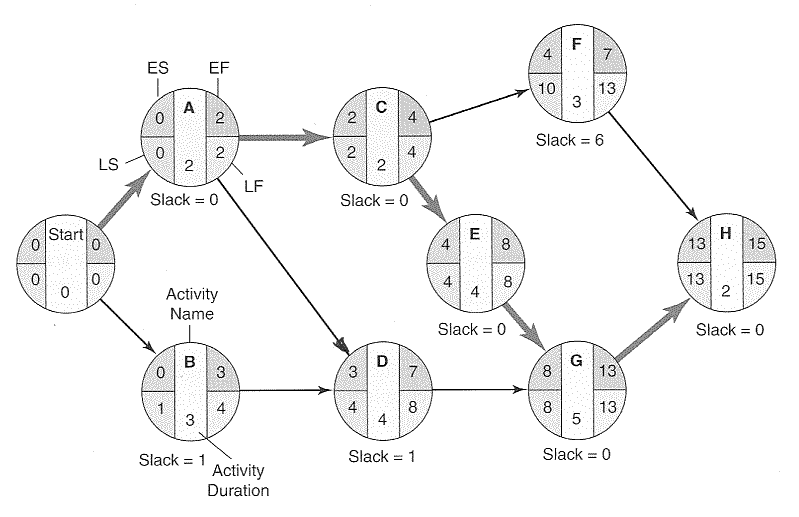

    6. Milwaukee Paper - Figs 3.11 with overlays    (p70)



  Activity    Slack = LS - ES

A
B
C

D
E
F

G
H

0 - 0 = 0
1 - 0 = 1
2 - 2 = 0

4 - 3 = 1
4 - 4 = 0
10 - 4 = 6

8 - 8 = 0
13 - 13 = 0

Critical path: A, C, E, G, H
